How to Choose a Solar Installer You Won't Regret: A Filipino Homeowner's Guide

A research-based consumer guide for Filipino homeowners — as of June 2026.

Published June 15, 2026 by C

Installation-guidelines-solar

DISCLAIMER — READ THIS FIRST

This guide is for general educational purposes only. It does not constitute legal, financial, or engineering advice, and it does not create a professional engagement between the author and the reader. All regulatory details (DOE accreditation requirements, ERC resolutions, net metering rules, PEC provisions, and PRC licensing requirements) are cited to the best of the author's knowledge as of May 2026, but laws, rules, and agency procedures change. Always verify current requirements directly with the relevant Philippine government agency before making decisions. The pricing estimates in this guide reflect market data from Q1–Q2 2026 and will vary by region, equipment brand, and installer. This guide does not endorse or recommend any specific installer, brand, or financial product.


Why This Guide Exists

Filipino consumer protection forums and solar community groups like r/SolarPH are full of the same story, told by different homeowners. They chose the cheapest quote, signed a two-page contract, and ended up with a system that underperforms, an inverter that keeps tripping, or, worse, an installer who has since disappeared and won't pick up the phone. A case documented in the r/SolarPH community involved a homeowner who lost an estimated ₱280,000 after a contractor folded six months post-installation, leaving behind a net metering application that was never filed with the distribution utility.

These are not rare exceptions. The Philippine solar market has grown fast, and accreditation enforcement has not always kept pace. Fly-by-night operators exist alongside legitimate companies, and the paperwork they share looks identical on the surface.

You're about to spend somewhere between ₱150,000 and ₱700,000 on a rooftop solar system [1, 2]. This guide shows you how to tell the two apart, with every claim sourced so you can verify it yourself.


1. Non-Negotiable Credentials to Verify Before Anything Else

Before you let any salesperson inside your home, ask for proof of the following. A legitimate installer will hand these over without hesitation.

DOE Accreditation (RA 9513)

The Department of Energy (DOE) accredits solar installation contractors under the Renewable Energy Act of 2008 (Republic Act No. 9513), which is the foundational law governing all renewable energy development in the Philippines [3]. The DOE institutionalized the Renewable Energy Service Contracting system to form agreements with the private sector for the exploration, development, and operation of RE systems [4].

Ask for the installer's DOE Renewable Energy Service Contractor (RESC) accreditation certificate and check it against the DOE's published list at energy.gov.ph. Accreditation is renewed periodically, so check the expiry date, not just the certificate number.

⚠ Verify with the DOE: Accreditation categories and renewal requirements have been subject to ongoing updates. Confirm current requirements directly with the DOE Renewable Energy Management Bureau (REMB) at (02) 8479-2900 or at energy.gov.ph.

PCAB License

Beyond DOE accreditation, a contractor performing rooftop installation work should hold a current Philippine Contractors Accreditation Board (PCAB) license issued by the Construction Industry Authority of the Philippines (CIAP). This license confirms that the company meets technical, financial, and organizational requirements for contractors performing electrical and structural work [5]. An unlicensed contractor cannot legally pull building permits or pass government inspections.

ERC and Net Metering

The Energy Regulatory Commission (ERC) oversees the rules for connecting your system to the grid under net metering. The net metering framework has been in place since 2013 and covers installations up to 100 kW [6].

In September 2025, the ERC issued amended net metering rules that significantly simplified the process. Distribution utilities must now publish application forms and processes on their websites; unused net metering credits can be banked and rolled over to future bills; and credits can be transferred to a new owner when property changes hands [6, 7]. ERC Chairperson Francis Saturnino Juan stated publicly that distribution utilities should require only "very limited, three or four requirements" to process applications [6].

Ask your installer: "How many net metering applications have you filed with [your DU], and what was the average processing time?" A typical timeline from application to approved meter is 3 to 6 months, depending on your DU [8]. If they fumble that answer, they haven't done it before.

Licensed Electrical Engineer Sign-Off

Every solar installation requires the electrical design to be signed and sealed by a Professional Electrical Engineer (PEE) or a Registered Electrical Engineer (REE) licensed by the Professional Regulation Commission (PRC). The Philippine Electrical Code (PEC) 2017 Edition, effective for new installations from 1 January 2019, is the legally adopted standard for all electrical work, and its enforcement is carried out through the Office of the Building Official/EE [9, 10]. PEE and REE signatories are legally accountable for the safety of installations they certify for 15 years [9].

Verify active license status at verification.prc.gov.ph.

Business Registration

Verify the company's registration with either the Securities and Exchange Commission (SEC) for corporations, or the Department of Trade and Industry (DTI) for sole proprietors. A legitimate contractor has nothing to hide here.

Local Building Permit

Any structural work on your roof requires a building permit from your local government unit (LGU). Solar racking systems qualify as structural work. An installer who skips this is putting your homeowner's insurance and LGU compliance at risk.


2. Technical Qualifications That Separate the Pros from the Pretenders

Credentials confirm the installer can legally operate. Technical qualifications tell you whether they actually know what they're doing.

Manufacturer Certification

Ask if the installer is an authorized dealer or certified installer for the panel and inverter brands they're proposing. A certified installer gets better warranty support from the brand and access to proper technical documentation. An unauthorized reseller may offer cheaper equipment, but you'll be fighting alone when something breaks.

PEC 2017 and IEC Standards Compliance

Your panels should comply with IEC 61215 (crystalline silicon modules) and IEC 61730 (safety qualification). Inverters must carry anti-islanding protection, which automatically disconnects your system from the grid during a power outage, protecting utility linemen working on downed cables during a typhoon.

The PEC 2017 Edition, Section 6.90.5 (which mirrors NEC Article 690.11) mandates DC arc-fault circuit interrupter (AFCI) protection for rooftop PV installations [11]. This is one of the most frequently skipped requirements in budget installations. Ask your installer specifically: "Does your design include DC AFCI protection per PEC Section 6.90.5?" If they look blank, walk away.

Surge and Lightning Protection

Skipping this in the Philippines is asking for trouble. A proper design includes DC surge protection devices (SPDs) on the array side and AC SPDs on the inverter output. If your quote doesn't mention surge protection explicitly, ask why. Given how frequently Luzon, Visayas, and Mindanao experience direct lightning strikes and power surges, installers who skip this are cutting corners on your most vulnerable asset.

Structural Assessment for Typhoon Wind Loads

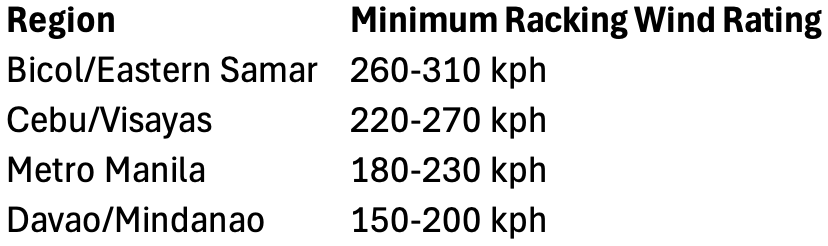

Your roof must be assessed against the National Structural Code of the Philippines (NSCP) 2015 Edition, which includes detailed provisions for wind load calculations tailored to typhoon-prone conditions [12]. The NSCP defines wind zones by geographic area, and the required wind load rating for your racking system depends on where you live [13]:


Source: pinas.solar, March 2026 [13]. Verify with your installer and a licensed structural engineer for your specific LGU.

A reputable installer performs detailed wind load calculations, not guesswork. The calculation must be signed by a licensed engineer and reflect your specific roof pitch, panel tilt angle, and location. Aerodynamic uplift forces are highest at roof edges and corners, where additional anchor points are required [14]. Ask for the structural load calculation document before signing anything.

Net Metering Experience With Your Specific DU

Net metering processing times and interconnection requirements vary significantly between Meralco and a rural electric cooperative (EC). Meralco has waived the Distribution Impact Study (DIS) fee for many residential accounts, while some electric cooperatives charge ₱1,500–₱5,000 for this study [8]. Some DUs have been slow to standardize requirements despite the ERC's 2025 amendments [7]. So don't settle for "yes, we do net metering." Pin them down: "Have you completed a net metering installation with [your DU]? Can you give me a reference contact at that utility?"


3. Red Flags: Trust Your Gut When You See These

Walk away if you encounter any of the following:

  • Vague or itemized-only quotations that don't specify panel wattage, inverter brand/model, cable grades, breaker ratings, or racking type.
  • No site assessment before quoting. Any competent installer needs to inspect your roof, measure shading, check your electricity bill, and assess your distribution panel before giving a final price.
  • Pricing dramatically below market. As of May 2026, quality on-grid installed systems range from approximately ₱38,000–₱65,000 per kWp depending on equipment tier and region; hybrid systems with batteries run higher [1, 2, 15]. Dramatically lower bids usually mean inferior components, undisclosed costs, or shortcuts on structural and safety requirements.
  • No written contract, or a contract shorter than four pages that omits system specs, payment schedule, warranty terms, and a completion timeline.
  • Refusal to show DOE/ERC/PCAB paperwork, or vague responses like "we're in the process of renewing."
  • High-pressure sales tactics. "This price is only good until Friday" or "we have limited slots" are classic modus of fly-by-night operators.
  • Cash-only payment demands, or requests for 100% downpayment before work begins.
  • No mention of building permits, or an offer to "handle it themselves" without explaining the process.



4. Seventeen Questions to Ask Before You Sign Anything

Bring this list to every consultation. Legitimate installers will welcome the questions.

  1. Can you show me your current DOE RESC accreditation certificate and expiry date?
  2. Do you hold a current PCAB license? What is your license number?
  3. What is your SEC or DTI registration number?
  4. Who is the licensed PEE or REE who will sign the electrical plans? Can I see their PRC ID?
  5. Have you completed net metering applications with [my DU]? How many, and how long did the last one take to approve?
  6. Are you an authorized dealer/certified installer for the panels and inverter you're quoting?
  7. What IEC certifications do the panels and inverter carry? Can I see the datasheets?
  8. Does your design include DC AFCI protection per PEC 2017 Section 6.90.5? What about DC and AC surge protection devices?
  9. Have you done a structural load calculation for my roof per NSCP 2015? Who will sign off on it?
  10. What is the wind rating of the racking system, and does it match the NSCP requirement for my area?
  11. Will you pull the LGU building permit? In whose name, and how long will it take?
  12. What does the workmanship warranty cover, for how long, and who pays for labor on warranty repairs?
  13. What is your guaranteed response time for warranty service calls?
  14. What happens to my warranty if your company closes or changes ownership?
  15. Who handles after-sales O&M: your own team or a subcontractor?
  16. Can you give me two or three completed-project references I can call, preferably customers of [my DU]?
  17. What is the full payment schedule, and what specific milestones trigger each payment?

5. What You Must Receive at Handover (Huwag palagpasin ito)

The day your system is commissioned, you should receive a complete handover package. Do not make the final payment until you have all of the following:

  • Single-line diagram (SLD) showing the complete electrical layout of your system, stamped by the licensed PEE/REE
  • As-built drawings reflecting the actual installed configuration (sometimes different from the design drawings)
  • Equipment list with serial numbers covering every panel, inverter, combiner box, and surge protection device
  • Warranty certificates from the manufacturer for panels and inverter (not just a photocopy of a general brochure)
  • ERC net metering application receipt or, ideally, the approved net metering certificate from your DU
  • LGU building permit and certificate of electrical inspection
  • Commissioning report showing actual system output measurements taken at startup
  • O&M manual and installer emergency hotline number in writing

If the installer says "we'll send those later," write it into the contract with a specific deadline and a penalty clause.


6. Warranty Norms in the Philippine Market (2026)

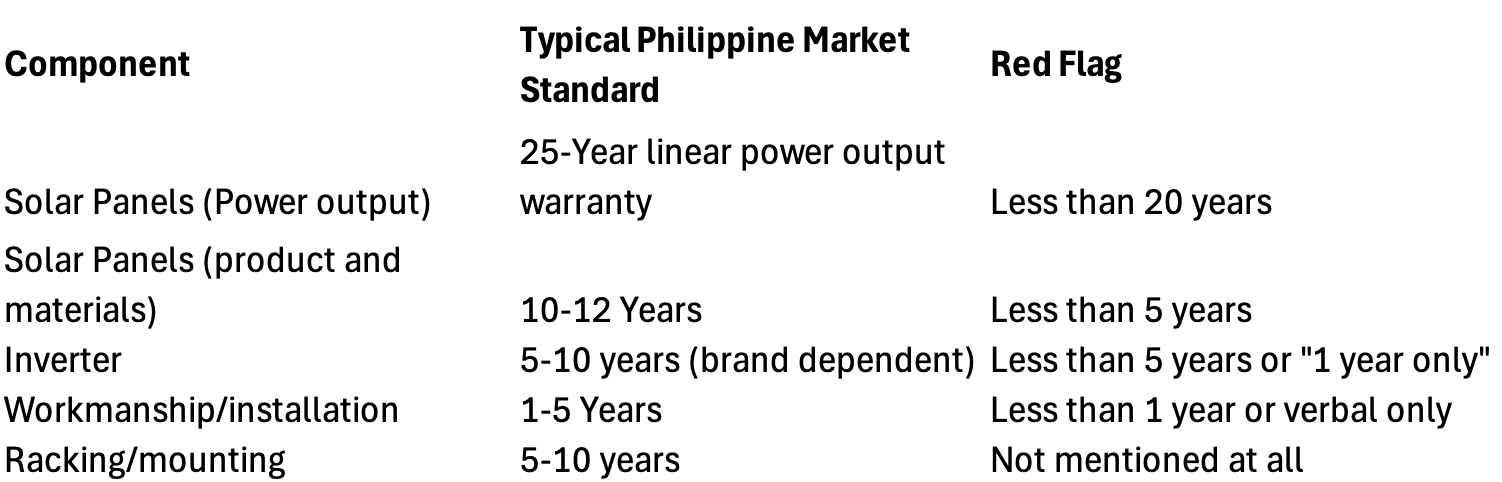

Here's what's standard and what should concern you:

A verbal warranty means nothing. Every warranty must be in writing, specify what is covered, and name who is responsible for service: the installer or the manufacturer's authorized service center.

Also ask who shoulders the labor cost for a warranty repair. Some installers cover parts but charge you for the technician's visit. Get this in writing.

One more thing: insurance. As of 2026, several Philippine insurers offer "solar expansion" riders on homeowner policies, typically priced at ₱1,500–₱4,500 per year, covering typhoon damage, theft, and accidental damage [13]. Most insurers require that the system was installed by a company with a valid building permit, which is another reason you cannot skip the permitting step.


7. What to Expect After Installation, and What to Do If They Disappear

A well-functioning 5 kWp system needs very little day-to-day attention: mostly monitoring via the inverter app and an annual cleaning. But when something goes wrong, response time matters.

In Metro Manila and major cities, a response within 48–72 hours for non-emergency issues is reasonable. In rural and provincial areas, five to seven working days is more realistic. If an installer consistently takes longer without communicating proactively, that's a sign of understaffing or disorganization.

If your installer goes out of business, you have three options.

First, contact the equipment manufacturer directly. Major inverter and panel brands maintain regional service centers or authorized service partners in the Philippines. Your serial numbers and warranty certificates (this is exactly why the handover package matters) are your ticket to that support.

Second, hire a different DOE-accredited installer to take over O&M. They can assess the system and take on the service relationship going forward.

Third, file a complaint with the DOE's REMB or the PRC if the issue involves the licensed engineer's work. For financial disputes, the DTI's Consumer Protection Group and the courts are available, though slow.

This is also why you should never pay 100% upfront. A reasonable payment schedule is 30–50% downpayment, 40–50% upon substantial completion, and 10–20% upon receipt of the approved net metering certificate. Holding the final payment until net metering is approved gives you real leverage.


8. Financing Pitfalls: Read Before You Sign a Loan

Several banks and quasi-banks offer "green loans" or "solar loans" in the Philippines. The Renewable Energy Act of 2008 (RA 9513) specifically directs government financial institutions, including the Development Bank of the Philippines (DBP) and Land Bank of the Philippines (LBP), to provide preferential financial packages for RE projects [17]. Ask these institutions about their current solar loan programs, as terms are updated periodically.

Some installers also offer in-house financing or lease-to-own arrangements. Here's what to watch out for.

For bank loans, compare the effective interest rate (EIR), not just the advertised monthly add-on rate. A 1% per month add-on rate translates to an EIR of roughly 18–22% annually. Run the numbers against your estimated monthly savings (Meralco's residential rate was ₱13.82/kWh as of March 2026 [18]) before committing.

In-house financing from the installer is convenient but often expensive. Interest rates of 24–36% annually are not unusual. Read every clause. Some contracts include an acceleration clause that makes the entire balance due immediately if you miss one payment.

Lease-to-own or solar-as-a-service arrangements are less common for residential systems but emerging. The appeal is zero upfront cost. The trap is that the system may not be yours for 10–15 years, and early buyout prices can be punishing. Ask what happens if you sell the house and whether the contract can be transferred to the new buyer. The ERC's 2025 amendments allow net metering credits to be transferred when a property changes hands [6, 7], but that applies to the grid connection, not necessarily the ownership of the solar equipment under a lease.

A common diskarte to watch for: some installers inflate the system price for financed buyers versus cash buyers without disclosing the markup. Always ask for the cash price first.


Sources and References

[1] Pinas.Solar. Solar Panel Cost Philippines 2026: Price Guide. Retrieved May 2026. https://solarph.pro/blog/solar-panel-cost-philippines (On-grid systems: ₱45–₱65 per watt installed.)

[2] Pinas.Solar. Solar Panel Price Philippines 2026: Complete Solar Panel Installation Cost Guide. Retrieved May 2026. Cites r/SolarPH community quotes (May 2026): on-grid ₱33,500–₱38,000/kW; hybrid ₱43,000–₱68,000/kW. https://www.pinas.solar/solar-guides/solar-panel-price-philippines/

[3] Chambers and Partners. Renewable Energy 2025 — Philippines: Trends and Developments. September 2025. https://practiceguides.chambers.com/practice-guides/renewable-energy-2025/philippines/trends-and-developments (Confirms RA 9513 as the primary RE legal framework; DOE's 35% RE target by 2030 under the Philippine Energy Plan 2023–2050.)

[4] U.S. Commercial Service / Trade.gov. Energy Resource Guide Philippines — Renewable Energy. https://www.trade.gov/energy-resource-guide-philippines-renewable-energy (DOE Renewable Energy Service Contracting system explained.)

[5] Solaren Power. The Hidden Value of Choosing a Fully Accredited Renewable Energy Company in the Philippines. May 2026. https://solaren-power.com/accredited-renewable-energy-company-philippines/ (PCAB licensing requirements for solar contractors.)

[6] PV Magazine. Philippines Updates Net-Metering Rules to Ease Adoption for 17,000 Users. September 15, 2025. https://www.pv-magazine.com/2025/09/15/philippines-updates-net-metering-rules-to-ease-adoption-for-17000-users/ (ERC amended rules: credit banking, rollover, property transfer; 100 kW cap confirmed; ERC Chairperson Juan's statement.)

[7] Philippine Daily Inquirer. ERC Eases Net Metering Rules to Boost Renewables. September 3, 2025. https://business.inquirer.net/544806/erc-eases-net-metering-rules-to-boost-renewables

[8] SolarInstallPH.com. Net Metering in the Philippines: Your Comprehensive 2025 Guide. December 2025. https://solarinstallph.com/blog/future-of-net-metering-philippines-solar/ (3–6 month typical timeline; DIS fee variations between Meralco and electric cooperatives.)

[9] Course Hero / IIEE. Philippine Electrical Code 2017 — PEE, REE Licensing and Accountability. Reference: PEC 2017 Edition via IIEE. https://www.coursehero.com/file/119587687/pec-pptpdf/ (PEE/REE sign-off carries 15-year safety accountability.)

[10] Electrician Philippines. Philippine Electrical Code Part 1 2017 Edition — New Provisions and Impacts. https://electricianphilippines.com/philippine-electrical-code-part-1-2017-edition-new-provisions-and-impacts/ (PEC 2017 enforcement by Office of the Building Official.)

[11] Filipino Engineer. Arc Fault Protection for Solar PV Systems: What PEC 2017 Requires. April 2026. https://filipinoengineer.com/blog/2026/04/arc-fault-protection-for-solar-pv-systems-what-pec-2017-requires.html (PEC 2017 Section 6.90.5 mandates DC arc-fault circuit interrupters; parallel reference NEC Article 690.11; effective January 1, 2019.)

[12] iDeCAD. NSCP 2015 — Structural Code of the Philippines. https://idecad.com/architecture-engineering-construction/building-design/nscp-2015/ (NSCP 2015 enhanced wind load provisions for typhoon-prone areas.)

[13] Pinas.Solar. Typhoon-Proof Solar in Philippines: What You Need to Know. March 2026. https://www.pinas.solar/solar-guides/typhoon-proof-solar-philippines/ (Wind load requirements by region; insurance rider pricing ₱1,500–₱4,500/year.)

[14] SolarInstallPH.com. Essential Wind Load Calculations for Safe Solar Panel Mounting in the Philippines. June 2025. https://solarinstallph.com/blog/wind-load-solar/ (NSCP wind load calculations; higher pressure at roof edges and corners.)

[15] SolarNRG Philippines. Solar Calculator Philippines. https://solarnrg.ph/solar-calculator/ (Average installed cost approximately ₱50,000/kWp.)

[16] Electrical Engineering Hub / AzadTechHub. Solar Panel Installation Cost In The Philippines (2026 Guide). May 2026. https://azadtechhub.com/solar-panel-installation-cost-in-the-philippines/ (25-year performance warranties; typical 4–7 year payback period.)

[17] ESCAP Policy Documents. Renewable Energy Act of 2008 (Republic Act No. 9513). https://policy.asiapacificenergy.org/node/908 (RA 9513 provisions on DBP/LandBank preferential financing for RE projects.)

[18] SolarTayo.com. Solar Panel System Calculator Philippines. Retrieved May 2026. https://solartayo.com/ (Meralco residential rate: ₱13.82/kWh as of March 2026.)

Weekly solar signal

Stay updated on PH solar

Get new guides, updated cost data, and free tool alerts - straight to your inbox.

Newsletter signups are coming soon. Read our Privacy Policy to learn how we handle information once signups are enabled.
